Industry Summit: Access Planning and
work-window productivity
Safer Faster Isolations
Andy Wilson, Head of Programme Systems Engineering
Network RailHistory & Drivers For Change
• The isolation process for 25kV OLE infrastructure has not changed substantially since the
system was introduced in the 1950’s
The process is labour intensive, involves the application of numerous
discrete earths often placed at locations remote from line side access points
It also involves multiple safety critical conversations between Nominated Persons and
the Electrical Control Operator (ECO) and between the ECO and the signaller.
Average current time to apply whole process in excess of 60 mins
• Meanwhile access to electrified routes in particular is at an even higher premium with white
period hours being continually eroded to provide more time for what the rail infrastructure is
there for – to run trains!
• The introduction of high output plant (generally requiring an isolation) has meant the cost of lost
production during these remaining precious white periods has risen exponentially
• And finally safety, the heavy reliance on human behaviours even though independent checking
is required throughout the process has resulted in an average of one serious life changing
event per yearKeeping everyone safe, every day… • Since 1998, there have been a total of 17 incidents which have resulted in a fatality or life-changing injury. • The Isolation Safety Review Phase 1 was initiated by the Group Asset Management Director in September 2011. • Building a network for the future means we anticipate increasing volumes on work on an expanding AC electrified lines. Currently, approx 8800 track km of Britain’s railway network is electrified using 25 kV AC overhead line. By the end of the next control period this will have increased to over 12000 km • ORR Network Availability targets require increasing adoption of protection arrangements - some lines remain open to traffic while work takes place on nearby isolated lines. • The review makes recommendations in a number of areas to reduce the likelihood and severity of electrical accidents on the AC electrified railway.
Isolation Review Phase 1 - areas of emphasis • Align staff roles and competence • Enhance safe systems of work near OLE and Permits to Work • Limit possibility and consequence of attempting to work on live equipment • Lead and assure railway electrical safety • Align work and isolation planning • Enhance Rule Book and Electrified Line Work Instructions 29987 (NR/SP/ELP/29987) • Early improvements to asset information • Potential early infrastructure interventions
What are/will we be doing differently as a result…
• Methods of demarcating isolated sites
• Critical success factors were indentified as
part of a cross industry & comparator study
– Benchmarking with National Grid
– Identification of key factors such as audit and
competence
• Application of the electrical Life Saving Rules

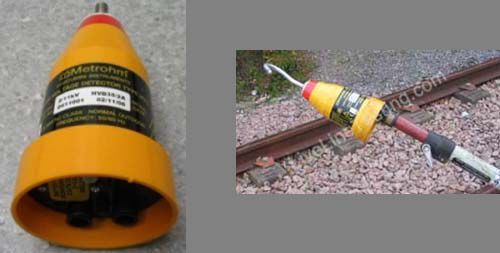

Always have valid permit to work where
required
Always test before applying earths
Never assume equipment is isolated –
always test before touchWhat we are doing differently as a result…(2)
• Generation of a Suite of Electrical Safety Principles
Principle No 1 Foreseeable Danger is to be avoided in all circumstances where tasks
are carried out on the electrified railway.
Principle No 2 Points of Isolation can be provided and controlled by either site staff
or ECR staff.
Principle No 3 Earths will be under the control of Senior Nominated Persons or
Nominated Persons on site.
Principle No 4 Appropriately rated Circuit Main Earths will be applied between the
points of Inadvertent Re-energisation and the worksite which are to
prevent inadvertent re-energisation giving rise to Danger.
Etc to Principle No 21 – still in draftIsolation Review Phase 2 Work streams investigated during Phase 2 • Investigate the potential for OLE isolation switching to be done by remote control • Remote operational interface through SCADA or IEC 61850 • Minimised power supply requirement • Arrangements must be configurable for installation at ALL points of OLE isolation • Proposed solutions are to be OLE focussed. Use of facilities within associated distribution equipment will be appropriate only if the arrangements are transparent to the OLE Nominated Person • Switching must be associated with individual part sections. That is to say that where two part sections connect, there must be individual switching associated with each part section. • Remote control application of the Circuit Main Earth (duplicate earth in current practice) • Circuit Main Earth to be rated to cater for 12 kA nominal fault level (i.e. 15 kA maximum). • Circuit Main Earth to have adequate security taking into account potential damage/metal theft. • Positive earth detection mechanism by suitable method • High reliability • Low maintenance • Climate (wind, rain, ice snow and hot weather) to be taken into account • Economic and affordable at first cost and full life cost
What we will be doing differently as a result
• Introduction of Project Advice Note 083 – Design Guidance For New Electrification Systems
• Robust Operations & Maintenance Strategies agreed as early as possible in the project life cycle
• Isolation & Earthing System Development
• Suppliers engaged in the development of suitable Fixed Earthing Devices (FED’s)

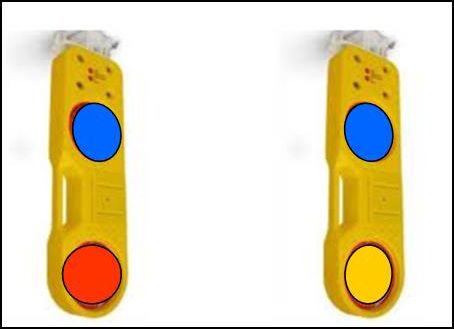

• Development of the “Pink Panels”
• Proposal to have two types of isolation
Limit of Access process
Instigated generally when no person is planned to come close
(600mm) or touch OLE equipment
Full Permit to Work
Generally invoked by a Senior Nominated Person and required
for person planning to come close or to touch OLE
equipment
• Preparation of a Roadmap detailing the proposed changes to the “Green Book” and associated
upgrading of electrical competency for a large proportion of staff.
• Utilising developments in protection & control to reduce overall disconnection timesQ&A
