M54 to M6/M6 Toll Link Road - Options consultation September 2017
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Road Investment Strategy
Roads period April 2015 to March 2020
Context - Road Investment Strategy
£15.2 billion investment in our major roads
Over 1,300 additional lane miles
Resurfacing 80% of the Strategic Road Network
£1.8 billion
Midlands Investment invested this
31 major road schemes including:
M54 to M6/M6 Toll Link road Road Period
M6 Junction 10 improvements
M42 Junction 6 improvements
RIS Announcement
M54 to M6/M6 Toll link road – adding a north-
facing access between the M54 and the M6 and
M6 Toll around junctions 10A and 11.
2Context for the scheme
Known issues in the area
• No direct motorway link from the M54
to the M6 north or M6 Toll
• Traffic from the M54 to the M6/M6 Toll
uses A460 and A449 / A5
• This traffic on A449, A5 and A460
contributes to local traffic congestion
• Journey times are almost doubled
during peak hours
• Air quality issues in the villages and
along the route
• High volumes of traffic and HGVs
contribute to poor facilities for
pedestrians, equestrians and
cyclists
3High Level Scheme Objectives
1. Relieve traffic congestion on the A460, A449 and A5
2. Provide more reliable journey times
3. Improve safety and reduce driver stress
4. Keep the right traffic on the right roads
• Reduce volumes of through-traffic in villages, particularly heavy
goods vehicles
• Improve access to and across the A460
5. Support economic growth by improved routes for east-west and
north-south traffic.
4Previous Consultation 2014 / 2015
Took place from December 2014 to January 2015 on 3 options:
Option A – a new road between M54 junction 1 and M6 junction 11
with alternative options taking the road to the west or east in the
vicinity of Hilton Hall.
Option B west and east – a new road between M54 junction 1 and
the M6 and M6 Toll at junction T8. This route had an alternative
alignment to the west or east in the vicinity of Hilton Hall.
Option C – north facing links added at M6 junction 10a, M54
widened between junction 1 and the M6 and M6 junction 10a – 11
converted to a 4 lane, all lane running smart motorway.
5Key Consultation Findings
There is generally good support for the scheme with 87% of
respondents supporting the need for improved road links between the
M54, M6, and M6 Toll
Public preferences :
Option C - 63% support
Option B - 22% support (of these 75% favoured Option B west)
Option A - 13% support
No Preference - 2%
Stakeholders (e.g. local authorities and business groups) preferences:
Option B - 49% support
Option C - 36%
Option A - 15%
6Development of improved options
Feedback from our initial consultation told us that further
assessment work was needed to meet the needs of our
customers and find the best solution.
Further assessment work
Our assessment work has focused on:
• mitigation measures to reduce the environmental impacts of Option B
• improving the traffic and economic performance of Option C
We have now developed 3 modified options.

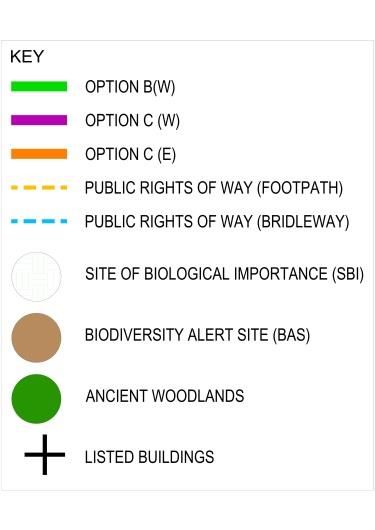

7Option B West
Option B West would bypass the
villages of Featherstone and
Shareshill to the east of the existing
A460. The road would pass to the
west of Hilton Hall, crossing the M6
north of junction 11. Junction 11
would remain unchanged with local
access to the M6 and M6 Toll
remaining the same.
8Option C West
This option would widen the
existing M54 from junction 1
towards the M6. The road
will continue northwards
towards the existing M6. The
route will then pass under
Hilton Lane and run north
towards the M6 at junction
11, then pass under the re-
aligned A460, crossing the
M6 north of junction 11.
Junction 11 would remain
unchanged with local access
to the M6 and M6 Toll
remaining the same.
9Option C East
This option would widen the
existing M54 from junction 1
towards the M6. The road will
continue northwards towards the
M6, affecting areas of the ancient
woodland at Burn’s Wood, Spring
Coppice and Keeper’s Wood. The
route will then pass under Hilton
Lane and run north towards the M6
at junction 11. The route will pass
under the re-aligned A460,
crossing the M6 north of junction
11. Junction 11 would remain
unchanged with local access to the
M6 and M6 Toll remaining the
same.
10Environmental
Considerations
• Green Belt and open
countryside
• Listed Buildings
• Ancient Woodland
• Sites of local and national
ecological interest
11Public Consultation
15 September 2017 to 13 October 2017
Public Events
Location Date Time
Shareshill Village Hall Friday 15 September 2017 1pm to 8pm
Featherstone and Hilton Saturday 16 September 2017 10am to 4pm
Community Centre
Essington Community Centre Monday 18 September 2017 1pm to 8pm
Webchat Wednesday 27 September 2017 11am to 2pm
12We would like your feedback on:
The 3 modified options
Any other views / comments / concerns
Deadline for all responses is 13 October 2017 (11.59pm)
Anyone can provide comments by:
15 October 2017 (11.59pm)
Completing our online questionnaire
Downloading a copy of the questionnaire from our website
Picking up a brochure and completing the questionnaire attached
You can respond by:
Emailing us at: M54toM6/M6tolllinkroad@highwaysengland.co.uk
Visiting our website: www.highways.gov.uk/M54toM6/M6Toll
Posting responses to: M54 to M6/M6 Toll Link Road, Highways England, The
Cube, 199 Wharfside Street, Birmingham, B1 1RN
13What happens after consultation?
Response analysis We will analyse and consider all consultation responses,
Late 2017 alongside ongoing technical work
If there is a compelling case for the scheme and a suitable
Preferred route announcement
option is selected, a preferred route will be announced
Late 2017
Following further on work on preferred route, we would
Statutory public consultation
consult on our proposals in line with DCO requirements
Autumn 2018
Following analysis of the statutory consultation responses, we
Submit DCO application will submit an application for Development Consent
Summer 2019
DCO decision Estimated date for Secretary of State decision on the scheme
Winter 2020
Estimated start of construction Start of construction
Spring 2021
14Questions?
