Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011

Page created by Milton Johnson

CONTINUE READING
Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011
Wind Project Finance
& Development
TERI University MTECH and MBA Guest Lecture
Wednesday, April 27, 2011
Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011
Introduction
• This presenters today are Sumit Kadakia and Alieda Baig, both members of the
  strategy and finance team at Emergent Ventures
• Emergent Ventures is a climate change and clean energy development firm
  o   Started as a carbon advisory business
  o   Has built a clean energy team over the past 3 years
  o   Currently working on a portfolio that spans a range of renewable energy technologies
      –   Biomass combustion
      –   Biomass gasification
      –   Waste –to-energy
      –   Solar
      –   Wind
  o   Wind is primary handled through a majority owned subsidiary, WinDForce Management
      Systems
Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011
What you should get out of today’s discussion

                    A general overview of the wind project
                    development cycle

                    Wind project fundamentals and economics

                    Key opportunities / challenges for
                    developing and funding projects in India
Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011
An overview of the wind industry in India

• 5th largest in terms of installed capacity
• Primary renewable energy source contributing
  over 70% of the total renewable energy in
  India                                                Country-wise wind power installation- June 2010
                                                                       (MW Installed)
• Very favorable environment, mature markets,     40,000
  low technology risk due to tested variations,
  substantial support from the government         30,000

• Numerous Indian and International WEG           20,000
  manufacturers active in India; this increases
                                                  10,000
  competition and consumer orientation; makes
  for easier market penetration in some cases         0
• CWET estimates that wind power potential is               USA    China Germany Spain      India    Italy

  at 70 GW; only ~12 GW is installed;
  opportunity is therefore huge
Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011
Basic components of a turbine and wind farm

                               690V        33KV       110KV

                                 DP Yard    Farm SS    Grid SS

                                              110/230KV
Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011
Wind Project Case: TN Wind
Setup
A colleague of yours has approached you to perform a feasibility study for a 100 acre
site in Tamil Nadu which should yield a 10MW wind farm. He has seen other wind
turbines in the area and believes he may be able to construct a farm in the region

He has a few basic details about the site:
• A wind resource assessment has been conducted and indicates an expected PLF of
  33%
• About half of the land is held by small farmers, the other half is held by a single
  large land-owner

Some requirements he informs you of:
• His company has a hurdle rate of 18% on equity investments
• Any investment made today must begin to generate cash by December 2012
Wind Project Finance & Development - TERI University MTECH and MBA Guest Lecture Wednesday, April 27, 2011
Process for wind farm development
                      Land          Technology
 Wind Resource                                      Obtaining
                  Identification   identification               Micrositing   PPA structure
  Assessment                                        approvals
                 and Acquisition   and sourcing
Finding a good wind site is the first step of the
development process
                          Land          Technology
  Wind Resource                                         Obtaining
                      Identification   identification               Micrositing   PPA structure
   Assessment                                           approvals
                     and Acquisition   and sourcing

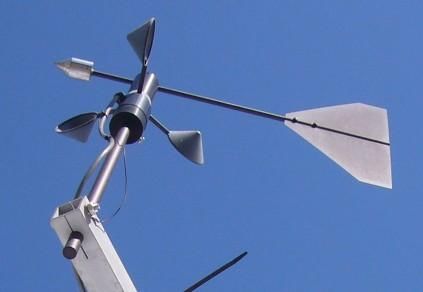

 What is it?      • A wind resource assessment (WRA) is an assessment used for
                    developers to determine the power output from a proposed wind
                    farm
   Why?           • Precision and accuracy is crucial for a WRA because this helps mitigate
                    the risk of farm under-performance

                  • There are typically three steps during a WRA process
  Process
                       • Preliminary Area Identification
                       • Area wind resource evaluation
                       • Micrositing
                  • At a minimum data must be collected for one year to understand the
 Standard
                    seasonal and diurnal variations in wind flow; 2-3 years of data
                    produces more reliable results
Finding a good wind site is the first step of the
development process
                      Land          Technology
 Wind Resource                                      Obtaining
                  Identification   identification               Micrositing   PPA structure
  Assessment                                        approvals
                 and Acquisition   and sourcing

       Preliminary area identification
Finding a good wind site is the first step of the
development process
                      Land          Technology
 Wind Resource                                      Obtaining
                  Identification   identification               Micrositing   PPA structure
  Assessment                                        approvals
                 and Acquisition   and sourcing

       Area wind resource identification
Land identification is a detail-oriented process that
must be tightly controlled
                          Land          Technology
  Wind Resource                                         Obtaining
                      Identification   identification               Micrositing   PPA structure
   Assessment                                           approvals
                     and Acquisition   and sourcing

 What is it?      • Land identification and acquisition is the process undertaken to find
                    available tracts of land, legally due-diligence the land and finally
                    purchase it
   Why?           • Can be done on a point or contiguous basis
                  • Better question is why should this be done right: land acquisition is a
                    make or break step for all renewable energy projects – especially as a
                    developer. No one wants a claim after turbine erection.
                  • Deploy land team at site
  Process
                  • Vet brokers / agents
                  • Have transparent negotiations for price
                  • Document collection / legal opinion / registration

 Standard
                  • Often a commercial call
How to pick the right turbine?
                       Land          Technology
  Wind Resource                                      Obtaining
                   Identification   identification               Micrositing   PPA structure
   Assessment                                        approvals
                  and Acquisition   and sourcing

There are many turbine manufacturers to choose between…
Choosing a turbine should be a techno-commercial
decision
                       Land                Technology
 Wind Resource                                                   Obtaining
                   Identification         identification                     Micrositing    PPA structure
  Assessment                                                     approvals
                  and Acquisition         and sourcing

                 Quantitative                 Qualitative
                 •Sweet area / MW             •Blade Airfoil
                 •Hub Height                  •Blade Manufacturing
                 •Annual Energy               •Power regulation
                  Output / MW                 •Generation system
                                              •Braking system

                                                                               Evaluate
                 Organizational               Operational
                                                                             commercially
                 •Structure in India to       •Track record of
                  take care of O&M             maintenance
                 •Spare parts                 •Track record of
                 •Liabilities from             availability
                  contracts
A few technical charts…
                       Land          Technology
  Wind Resource                                      Obtaining
                   Identification   identification                    Micrositing   PPA structure
   Assessment                                        approvals
                  and Acquisition   and sourcing

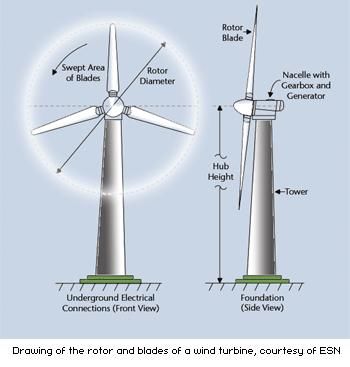

Sweep area

                                                                 Power Curve
Approvals for wind: Evacuation and Land (if necessary)
                      Land          Technology
 Wind Resource                                      Obtaining
                  Identification   identification               Micrositing   PPA structure
  Assessment                                        approvals
                 and Acquisition   and sourcing

  • Three main types of permitting required for farms:
        • No objection certificates (NOCs)
        • Evacuation capacity
        • Forest land clearance (if using forest land)

  • In TN, Evacuation used to be promised to wind farms based on a system called
    IDC (Infrastructure Development Charges).
        • Developer / owner would pay about 26 lakhs / WTG
        • TN would provide capacity and maintain substation
  • Demand was so high, TN was unable to keep up

  • Now developers can file to build their own substation and evacuation systems.
Micrositing – the fine tuning of turbine placement
within a farm
                          Land          Technology
  Wind Resource                                         Obtaining
                      Identification   identification               Micrositing   PPA structure
   Assessment                                           approvals
                     and Acquisition   and sourcing

 What is it?      • Micrositing is the process of quantifying the small-scale variability of a
                    wind resource over a given terrain

   Why?           • Necessary to conduct especially when there is surface roughness

                  • Typically done with specific micrositing or wind-farm development
  Process           software:
                       • WAsP
                       • Meteodyne
PPA structures available in TN
                      Land          Technology
 Wind Resource                                      Obtaining
                  Identification   identification               Micrositing   PPA structure
  Assessment                                        approvals
                 and Acquisition   and sourcing
Wind Project Case: What do you need to know about
this project?
Setup
A colleague of yours has approached you to perform a feasibility study for a 100 acre
site in Tamil Nadu which should yield a 10 MW farm. He has seen other wind turbines
in the area and believes he may be able to construct a farm in the region

He has a few basic details about the site:
• A wind resource assessment has been conducted and indicates an expected PLF of
  33%
• About half of the land is held by small farmers, the other half is held by a single
  large land-owner

Some requirements he informs you of:
• His company has a hurdle rate of 18% on equity investments
• Any investment made today must begin to generate cash by December 2012

                                             Based on this information, what are the 10
                                                initial questions to ask your friend?
Recommended areas of inquiry
              • Is the land contiguous?                      • What model turbine is the
   Land       • Do all land holders have        Turbines       project using and why?
                clear title?                                 • What is the land
                                                               requirement for a single
                                                               turbine?
              • Do we have a primary-                        • What kind of state / national
   WRA          source WRA?                    Regulatory      incentives are in place ?
              • If so, how many months of                    • Will they be applicable for
                data?                                          this project?

              • Is there evacuation capacity                 • Will the project be eligible
Evacuation      available in the region?         Credits       for CERs and RECs?
              • Does the project have                        • Any other benefit
                approval to expand
                capacity?
              • What is the expected mode                    • What is the total project
                                               Cost (CAPEX
Power sales     of power sales?                                cost?
                                                and OPEX)
              • Are there LOIs in place?                     • What operational costs will
                                                               the project face?
Detailed information about the project
              • Land purchased on a point                    • Project uses 1.8 MW Vestas
   Land         basis                            Turbines      turbines
              • Detailed land title diligence                • Rotor diameter of 100M
                pending

              • Primary WRA with 2 years of                  • Preferential tariff for SEB sales
   WRA          data                            Regulatory   • GBI
              • PLF of 33% is a P50 PLF                      • Preferential transmission rates

              • No, but permission to build                  • Project will be eligible for
Evacuation      substation to handle project     Credits       CERs regardless of power
                capacity                                       sales methodology
                                                             • Eligibility for RECs if no
                                                               preferential treatment
              • Group captive and SEB sales        Costs     • 7 Cr / MW
Power sales     are both possible               (CAPEX and   • O&M & Insurance of 2% of
              • LOIs in place with 5 off-         OPEX)        Project Cost
                takers                                       • Interest cost of 11%
                                                             • Transmission costs
Summary
• Wind project development is approximately a 1.5-2 year play if done properly

• WRA is the most important step – the other pieces can be re-done at a later point

• Evacuation and land are currently the two largest constraints

• PPA structuring will often have the largest impact on project economics
Questions?
Wind project finance
Wind project finance overview
• Limited recourse or “project finance”
  o   Debt is backed only by the project assets and the revenues they are able to generate
  o   In case of default, the lender cannot pursue the non-project assets or revenues of equity
      holders/project promoters
• Be prepared for lots of contracts!

                             Lenders                 Investors
                      Loan Agreement
                                                      Share Purchase Agreement

                      WTG Purchase                                  Off-taker/s
   Turbine            Agreement
 Manufacturers                          Project Co      Power
                      Construction                      Purchase
                      Agreement                         Agreement

                           O&M
  O&M Provider
                           Contract
Wind project finance overview: Incentives
• Given current market and technology, wind projects cannot compete with thermal
  projects on price alone
• Public incentives are key to making wind competitive :
  o   Feed-in Tariffs
  o   Renewable Energy Certificates (RECs)
      –   “Environmental Attributes” corresponding to 1 MW of electricity generated
      –   Tradable to meet state targets
  o   Certified Emissions Reductions (CERs)
      –   Carbon reductions generated through the Clean Development Mechanism
  o   Generation-Based Incentives
      –   Rs. 0.50/unit (capped at Rs 62 lakh/MW and Rs. 15.5 lakh/MW annually)
  o   Accelerated Depreciation
      –   Up to 80% of the project in the first year
Wind project finance overview: Incentives
                           For a Sample 25MW Wind Project in Tamil Nadu, REC/CER sales drive profits

Equity IRR (%)
     45%                                                              38%                39%           39%

     40%                                            36%

                                                                                         1%
     35%
                                                                       2%
     30%                                             20%

     25%                           16%

     20%                                                                                                39%

     15%

     10%                           11%

      5%
                 6%
      0%
             Base tariff     + REC (at 1.5 INR + REC (at 3.9 INR + CER (at 8 EUR / + CER (at 12 EUR    Total
                                  /unit)            / unit)       tonne of CO2) / tonne of CO2)
Wind project case continued: PPA Structure
• What are the benefits of selling to the state electricity board vs. to captive
  consumers?

Model                         SEB                           Group Captive
Tariff (INR) / unit           3.39                          4.0
Availability of RECs          No                            Yes
Preferential transmission     Yes, 5%                       No, ~11%
charges
Credit risk                   None, but late payment        Dependent upon off-
                              likely                        taker specifics and
                                                            number of consumers

                                                   Friend decides to select group captive
                                                  because of the availability of the higher
                                                        recognizable tariff and RECs
Wind project finance overview: Risk Assessment
• Credit analysis is key! Identify the risks in the project, project sensitivities and
  appropriate mitigation strategy.
• Contracts must clearly demonstrate roles and scope of different counterparties.
   Risk                 Examples                             Mitigation Strategies

   Regulatory           Change in tax regime; eligibility    •   Price-certain long-term PPA
                        for incentives                       •   Take-or-pay agreements
                                                             •   Diversified revenue streams
   Construction         Project delays and cost over-runs    •   Parent company guarantees
                                                             •   Liquidated damages
   Operational          High O&M costs; machine              •   Performance guarantees
                        breakdowns                           •   Insurance

   Sales                Off-takers do not pay; terminate     •   Credit analysis of off-takers
                        the PPA                              •   1-3 mo L/C

   Market               Unexpected changes in exchange       •   Swaps or other hedging strategies
                        rates, interest rates or inflation   •   Fixed rate debt
                                                             •   Government guarantees/support
Wind project case continued: Bank Financing
• Your friend has proceeded with the project and is now seeking funding from
  domestic banks. He has asked you for your opinion on willingness for banks to fund
  such a project with non-recourse financing and has provided you with the following
  returns information below. Do you think this is possible?
Model                       At P50 PLF with 1.5 REC    At P90 PLF, no RECs, no
                            and 8 EUR CERs             CERs
Equity IRR                  18%                        5%
Project IRR                 13%                        7%
Average DSCR                1.95x                      1.42x
Minimum DSCR                1.68x                      1.27x
Loan period                 10 years, 1 year           10 years, 1 year
                            moratorium                 moratorium
Leverage                    70% debt / 30% equity      70% debt / 30% equity
Interest rate on debt       11%                        11%
Wind project case continued: Bank Financing
Conclusions
• Banks will always conduct a credit analysis at your “worst-case” scenario
• If the project does not meet guidelines in this scenario, banks will often ask for a
  change in the project’s leverage. This can be done in one of three ways:
   o   Setting up a debt service reserve account (DSRA) of typically 6 months
   o   Providing parent company guarantees and /or letters of credit
   o   Reducing the debt / equity ratio
• However, there are factors on the promoter’s side that can influence banks
  willingness to lend
   o   Relationship with bank
   o   Track record in industry
   o   Adjust loan repayment schedule to align with revenue projections (e.g. balloon, principle
       moratoriums)
• Banks will look beyond pure return matrix and seek additional comfort on contract
  terms and conditions
   o   Break up of project costing
   o   Warranties
   o   Liquidated Damages
Questions?
Thank you!

         Can be reached at:

 alieda.baig@emergent-ventures.com

sumit.kadakia@emergent-ventures.com
       sumitkadakia@gmail.com
You can also read
