YOUR PANELISTS
Bill Cornelius, PE Ben Irwin Rachael Kuroiwa Nancy Ford
City of Arvada City of Arvada City of Arvada City of Arvada
Project Chief Communications Communications Council Member,
Manager Director Manager - Infrastructure District 1
J Parker Andi Schmid, PE Will Kerns, AICP Geoff Mestas, PE
HC Peck & Associates Ulteig Ulteig Muller Engineering
ROW Owner’s Owner’s Design Project
Acquisition Representative Representative Manager
Larry Walsh Mia Migdall
SEMA Construction SEMA Construction
Project Communications
Manager ManagerMeeting Overview
Welcome to the Virtual Presentation for the W 72nd Ave Bond Project. During this presentation, our Project Team will
update you on the corridor design, tentative construction schedule, next steps, and how to submit your questions.
This meeting is being recorded.
The project team will post answers to questions we receive
during the meeting and through the digital comment card to
the project web page and to the project email list.
Time:6 – 7 p.m.• Day: October 27, 2020 arvada.org/w-72nd-avenue-project
If you are unable to join us at the open house, you will be able to view the virtual presentation on the project website
listed above the next day. If you submitted questions after the deadline for this meeting (October 23, 2020), your
questions will be addressed with the questions and comments we receive from this meeting.
Please provide questions in the Q&A chat window or
via our Digital Comment Card on the project website by November 3rd, 2020.PROJECT AREA

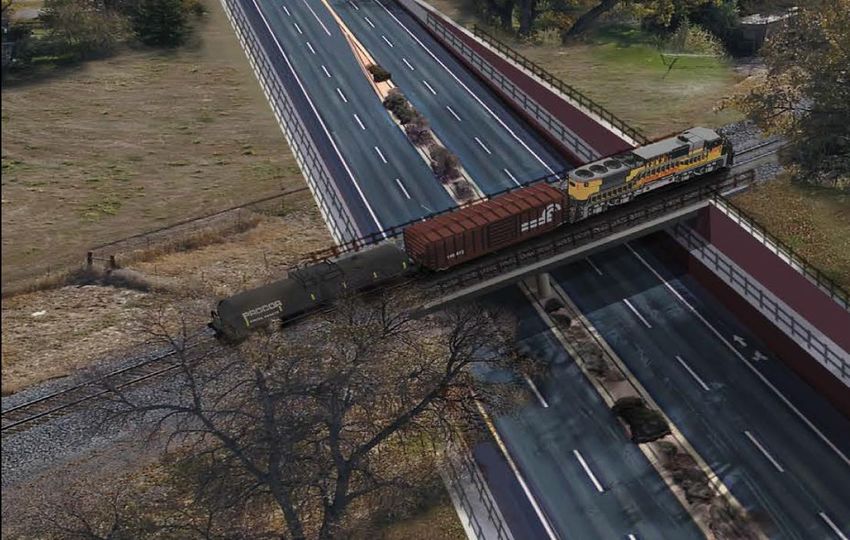

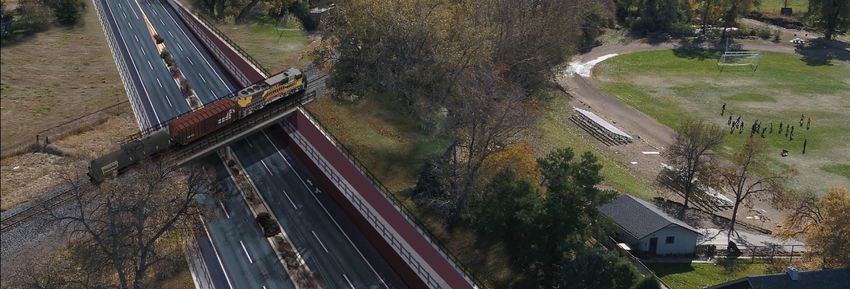

Signalized Intersection Utility & Drainage Replace existing at-grade railroad crossing
Improvements Improvements with an underpass under railroad tracks
2 Vehicular Lanes each direction with
dedicated bicycle and pedestrian
facilities in each direction between
Kipling St. and Simms St.COMMUNITY BENEFITS
Improve traffic flow through Increase safety and Resolve drainage
the corridor by eliminating comfort for pedestrians issues along W 72nd
the at-grade RR crossing, and cyclists by adding Avenue
widening the roadway, and bike lanes and
upgrading traffic signal sidewalks
equipmentPROJECT TYPICALS
WHERE ARE WE NOW? ROW Roadway/RR Early Utility Begin Construction Acquisition Underpass Design Relocations May 2021 Process 70% complete
CONSTRUCTION TIMELINE
This schedule is subject to change
Color Legend
Swadley to Oak
Construction
Summer 2021- Dec 2022 Oak to Kipling SWADLEY TO OAK OAK TO KIPLING CONSTRUCTION
We are Here Construction CONSTRUCTION* CONSTRUCTION* CLOSEOUT
Aug 2021 – Spring 2023
Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4
2020 2021 2022 2023
Underpass & Site Project
Early Utility 100%
Relocations Railroad
UPRR Bridge Clean-up Complete
Feb 2021-Jun Underpass Construction and
2021 Start Demobilization
Plans
Complete
*Information about Access Points and Closures can be found on the project website at arvada.org/w-72nd-avenue-projectRIGHT OF WAY ACQUISITION PROCESS*
1. Final Design Configuration & ROW Limit Determination.
2. Legal Exhibits Created & ROW Acquisition Limits are Staked at the Affected Property.
3. Notice of Intents are Sent via Certified Mail to Affected Homeowners.
4. Appraisals are then Completed. * Some Property Owners
are in different stages of
this process with us.
5. Offers & Negotiations are then Finalized**.
** We anticipate offer letters for some parcels will go out within the next 3-4 weeks.Noise Studies
Topics of Community Interest Related to Noise Studies Thus Far…
We’ve gotten variety of questions and have provided answers in the form of an FAQ Fact Sheet that can be
found on the project website listed at the end of this presentation.
Those topics that we responded to included:
▪ Information about the Noise Study and ▪ Other Sound Barriers on Nearby
Outcome Determination Factors Projects
▪ Time and Location Data was Collected
Important Highlights:
▪ The City of Arvada is following the FHWA’s Traffic Noise Analysis and Abatement Guidelines which have determined
that this project does not require a noise wall.
▪ Traffic data was collected and used, along with previous average daily traffic (ADT) for the corridor and adjusted
using growth factors to represent peak-hour conditions for both the existing condition model and future condition
(2020) noise model. This predictive model was used to estimate noise conditions at more than 537 receptors of
noise for future conditions and is used to predict the one-house worst case scenario in the year 2040.
▪ As a result of the Traffic Noise Analysis, design proceeded with wood fencing option.COMMUNITY BENEFITS
The team heard feedback from the community and was able to act on it.
Improvements Being Made
▪ Widen W. 72nd Ave. between Swadley Court and Kipling Street to match the road east of
Kipling, eliminating the bottleneck.
▪ Create an underpass at the Union Pacific Railroad crossing near Oak St. to eliminate
traffic backups.
▪ Add bike lanes.
▪ Add sidewalks for pedestrians.
▪ Upgrade signalized intersections with the latest traffic signal equipment and technology.
▪ Resolve significant drainage issues along W. 72nd Ave.LEARN MORE AND STAY UPDATED
Share with us your questions on how the W. 72nd Ave. improvements
affect you by submitting your questions in the Q&A chat window
of this virtual meeting.
Visit our website at arvada.org/w-72nd-avenue-project to learn more
about the project, to sign up for our project email list, and to fill
out the Digital Comment Card at: https://bit.ly/37ISHal
Call or email the Project team at (720) 314-8342 or
w72ndavenue@gmail.comNEXT STEPS?
What we are Doing…
✓ The project team will gather and respond to all of the questions by the close of the public
comment period.
✓ We will summarize the meeting and the answers to the questions we received in the chat window
and those from the Digital Comment Card.
✓ We encourage you sign up for the email list on the project website to stay up to date on the
progress of the project.
✓ We will use this email list through project construction to communicate about schedule and
traffic impacts.
The Digital Comment Card Closes on
NOVEMBER 3, 2020THANK YOU Share with us your questions the W. 72nd Ave. improvements affect you by submitting your questions in the chat window of this virtual meeting. Visit our website at arvada.org/w-72nd-avenue-project to learn more about the project, to sign up for our project email list, and to fill out the Digital Comment Card at https://bit.ly/37ISHal Call or email the Project team at (720) 314-8342 or w72ndavenue@gmail.com
