Environmental and Social Monitoring Report
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Environmental and Social Monitoring Report Project Number: 49001-003 Semi-Annual Report January – June 2021 August 2021 FIJI: Urban Water Supply and Wastewater Management Investment Project, Tranche 1 Prepared by SMEC for the Water Authority of Fiji and the Asian Development Bank. This environmental and social monitoring report is a document of the borrower. The views expressed herein do not necessarily represent those of ADB's Board of Directors, Management, or staff, and may be preliminary in nature. In preparing any country program or strategy, financing any project, or by making any designation of or reference to a particular territory or geographic area in this document, the Asian Development Bank does not intend to make any judgments as to the legal or other status of any territory or area.
SMEC INTERNAL REF. 5035017 DBO Contract ICB 1.1.1 and Gravity Main Contract ICB 1.1.2: Semi-Annual Safeguards Monitoring Report for January to June 2021 Construction Management and Supervision of Rewa River Water Supply Scheme Reference No. CS02B Prepared for Water Authority of Fiji 16 August 2021
Document Control
Document Control
DBO Contract ICB 1.1.1 and Gravity Main Contract ICB 1.1.2: Semi-Annual Safeguards Monitoring Report for
Document
January to June 2021
File Location Project Workspace
Project Name: Construction Management and Supervision of Rewa River Water Supply Scheme
Project Number: 5035017
Revision Number Final
Revision History
Revision No. Date Prepared By Reviewed By Approved for Issue By
Final 16 August 2021 Shilti Shayal Stephen Bayley Zahid Iqbal
1.0 30 July 2021 Shilti Shayal Stephen Bayley Zahid Iqbal
Kevin Horn
Issue Register
Distribution List Date Issued Number of Copies
Water Authority of Fiji 16 August 2021 5
Asian Development Bank
SMEC Company Details
Approved by Zahid Iqbal
Address Level One, 313-335 Flinders St, Townsville City, QLD 4810, Australia
Signature
Telephone +(61) 4729 6720 Facsimile +61 4 2414 5047
Email zahid.iqbal@smec.com Website www.smec.com
The information within this document is and shall remain the property of:
Water Authority of Fiji
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 2
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiImportant Notice Important Notice This report is confidential and is provided solely for the purposes of the Semi-Annual Safeguards Monitoring Report that WAF is required to submit to ADB for the Fiji Urban Water Supply and Wastewater Management Investment Programme. This report is provided pursuant to a Consultancy Agreement between SMEC Australia Pty Limited (“SMEC”) and Water Authority of Fiji (WAF), under which SMEC undertook to perform a specific and limited task for Water Authority of Fiji. This report is strictly limited to the matters stated in it and subject to the various assumptions, qualifications and limitations in it and does not apply by implication to other matters. SMEC makes no representation that the scope, assumptions, qualifications and exclusions set out in this report will be suitable or sufficient for other purposes nor that the content of the report covers all matters which you may regard as material for your purposes. This report must be read as a whole. The executive summary is not a substitute for this. Any subsequent report must be read in conjunction with this report. The report supersedes all previous draft or interim reports, whether written or presented orally, before the date of this report. This report has not and will not be updated for events or transactions occurring after the date of the report or any other matters which might have a material effect on its contents or which come to light after the date of the report. SMEC is not obliged to inform you of any such event, transaction or matter nor to update the report for anything that occurs, or of which SMEC becomes aware, after the date of this report. Unless expressly agreed otherwise in writing, SMEC does not accept a duty of care or any other legal responsibility whatsoever in relation to this report, or any related enquiries, advice or other work, nor does SMEC make any representation in connection with this report, to any person other than Water Authority of Fiji. Any other person who receives a draft or a copy of this report (or any part of it) or discusses it (or any part of it) or any related matter with SMEC, does so on the basis that he or she acknowledges and accepts that he or she may not rely on this report nor on any related information or advice given by SMEC for any purpose whatsoever. DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 3 1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017 JANUARY TO JUNE 2021 16 August 2021 Construction Management and Supervision of Rewa River Water Supply Scheme Prepared for Water Authority of Fiji
Table of Contents
Table of Contents
1 Introduction ............................................................................................................................................................ 8
1.1 Project Background................................................................................................................................................ 8
1.2 Purpose of the Report ............................................................................................................................................ 8
2 General Overview .................................................................................................................................................. 9
2.1 Contract Details...................................................................................................................................................... 9
2.2 Employer Details .................................................................................................................................................... 9
2.3 Donor Agencies ...................................................................................................................................................... 9
2.4 Employer Representatives and Consultant .......................................................................................................... 9
2.5 The Contractor ....................................................................................................................................................... 9
3 Project Description .............................................................................................................................................. 10
3.1 DBO Contract ....................................................................................................................................................... 10
3.2 Gravity Main Contract ........................................................................................................................................... 11
4 Project Progress During January – June 2021 .................................................................................................. 12
4.1 DBO Component .................................................................................................................................................. 12
4.2 Gravity Main Component ..................................................................................................................................... 14
Underground Pipeline Installation ...................................................................................................... 15
4.3 Planned Work for Next Quarter (July to September 2021) ............................................................................... 16
DBO Contract....................................................................................................................................... 16
Gravity Main Contract ..........................................................................................................................17
5 Environmental Safeguards Monitoring .............................................................................................................. 18
5.1 Status of Compliance with Environmental Safeguards Monitoring .................................................................. 18
5.1.1.1 Environment Monitoring Committees ................................................................................................ 23
5.1.1.2 Water Quality Monitoring .................................................................................................................... 23
5.1.1.3 Workers’ Health and Safety ................................................................................................................ 24
5.2 Assessment of Compliance with Environment, Health and Safety .................................................................. 25
Summary of Environmental, Health and Safety Non-Compliances Observed During Daily
Inspections for DBO Contract ............................................................................................................ 25
Summary of Environmental, Health and Safety Non-Compliances Observed During Daily
Inspections for GM Contract .............................................................................................................. 27
Summary of Notice to Contractor (NTC) Issued for breaching Environmental, Health and Safety
Conditions ............................................................................................................................................ 29
5.3 Anticipated Compliance for the Next Quarter (July to September 2021) ........................................................ 32
6 Social Safeguards and Gender Monitoring ........................................................................................................33
6.1 Public Consultation and GRM .............................................................................................................................. 33
Public consultation activities WAF and by Contractor ..................................................................... 33
6.1.1.1 Summary of Key Issues Discussed During Public Consultations ..................................................... 33
Grievance Redress Mechanism .......................................................................................................... 34
7 Land Acquisition and Resettlement Monitoring ................................................................................................ 35
Progress of Land Acquisition and Resettlement Activities .............................................................. 35
7.2 Gender Action Plan .............................................................................................................................................. 35
GAP Monitoring ................................................................................................................................... 35
Gender Implementation Activities ...................................................................................................... 36
7.3 Assessment of Compliance with Social Safeguards and Gender Monitoring ................................................. 37
Record of Non-Compliance ................................................................................................................ 37
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 4
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiTable of Contents
Appendices
EMC Meeting Minutes ........................................................................... Error! Bookmark not defined.
Water Quality Monitoring Report.......................................................... Error! Bookmark not defined.
Public Consultation Report ................................................................... Error! Bookmark not defined.
GRC Meeting Minutes ........................................................................... Error! Bookmark not defined.
List of Tables
Table 1: Components of the DBO Contract ICB1.1.1 ..................................................................................................... 10
Table 2: The list of temporary facilities for the DBO Contract ..................................................................................... 10
Table 3: List of facilities for the Gravity Main (ICB1.1.2) Contract ................................................................................ 11
Table 4: Status of the DBO Construction Works........................................................................................................... 12
Table 5: The Status of temporary facilities for the DBO Contract ............................................................................... 12
Table 6: Status of Gravity Main Construction Works ................................................................................................... 14
Table 7: DBO CEMP Compliance Status ........................................................................................................................ 18
Table 8: GM CEMP Compliance Status .......................................................................................................................... 21
Table 9: Summary of Environmental, Health and Safety Non-Compliances Observed During Daily Inspections for
DBO Contract ................................................................................................................................................................... 25
Table 10: Summary of Environmental, Health and Safety Non-Compliances Observed During Daily Inspections for
GM Contract .................................................................................................................................................................... 27
Table 11: Summary of Notice to Contractor (NTC) Issued for breaching Environmental, Health and Safety
Conditions ........................................................................................................................................................................ 29
Table 12: Summary Information on the Consultation carried out between January to June 2021 ...........................33
Table 13: WAF Grievances Monitoring Table as at 30th June 2021 ........................................................................... 34
Table 14: Land Acquisition Status for River Intake and Alternate Route (1.8 km) ...................................................... 35
Table 15: Number of additional Local/Chinese Staffs hired by the Contractor during January-June 2021 .............36
Table 16: Total Chinese Workers as at 30 June 2021 ..................................................................................................36
Table 17: Staffing Status as at 30 June 2021 (Local and Chinese) .............................................................................36
List of Figures
Figure 1: Current status of DBO Construction Site ....................................................................................................... 14
Figure 2: Current status of Gravity Main pipe installation site ..................................................................................... 16
Figure 3: EMC site inspection by the stakeholders ...................................................................................................... 23
Figure 4: GRC meeting and site inspection by the stakeholders................................................................................ 34
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 5
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiList of Abbreviations List of Abbreviations ADB Asian Development Bank AIDS Acquired Immune Deficiency Syndrome APs Affected Persons CAR Corridor Access Request CEMP Construction Environment Management Plan CPP Consultation and Participation Plan CSC Construction Supervision Consultant DBO Design, Built and Operate DoE Department of Environment DoL Department of Lands EA Executing Agency EARF Environmental Assessment and Review Framework EIA Environment Impact Assessment EIB European Investment Bank EFL Electricity Fiji Limited EMP Environment Management Plan FAM Facility Administration Manual FRA Fiji Roads Authority GAP Gender Action Plan GCF Green Climate Fund GM Gravity Main GRC Grievance Redress Committee GRM Grievance Redress Mechanism GSA Greater Suva Area Ha Hectare HIV Human Immunodeficiency Virus HSP Health and Safety Plan IA Implementing Agency IEE Initial Environment Examination IES International Environment Specialist IPMU Investment Programme Management Unit ITLTB I-Taukei Land Trust Board ISSGS International Social Safeguards and Gender Specialist IPC Interim Payment Certificate LARF Land Acquisition and Resettlement Framework LARP Land Acquisition and Resettlement Plan ML Million Litres ML/D Million Litres per Day MoE Ministry of Economy MIMS Ministry of Infrastructure, Metrological Services MOU Memorandum of Understanding MSCL pipe Mild Steel Cement Lined pipe MSDS Materia Safety Data Sheet NESSGS National Environmental, Social Safeguards and Gender Specialist NTC Notice to Contractor NTE Notice to Engineer OHSP Occupational Health and Safety Plan PPE Personal Protective Equipment RRWSS Rewa River Water Supply Scheme DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 6 1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017 JANUARY TO JUNE 2021 16 August 2021 Construction Management and Supervision of Rewa River Water Supply Scheme Prepared for Water Authority of Fiji
Introduction SH SinoHydro SHJV SinoHydro-HDEC JV SPM Special Projects Manager SPS Safeguards Policy Statement SRP Sediment Retention Pond STIs Sexually Transmitted Infections Sqm Square metre TMP Traffic Management Plan TNK Turaga-ni-Koro TOR Terms of Reference WAF Water Authority of Fiji WMP Waste Management Plan WTP Water Treatment Plant DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 7 1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017 JANUARY TO JUNE 2021 16 August 2021 Construction Management and Supervision of Rewa River Water Supply Scheme Prepared for Water Authority of Fiji
Introduction
1 Introduction
1.1 Project Background
The Urban Water Supply and Wastewater Management Investment Programme is financed by Asian Development
Bank (ADB) loan with co-financing from the European Investment Bank (EIB), the Green Climate Fund (GCF) and
counterpart funding from the Government of Fiji. The executing agency (EA) is Ministry of Economy and the
implementing agency (IA) is Water Authority of Fiji (WAF). The Rewa River Water Supply Scheme (RRWSS) is aimed
to address the current and future shortfall in bulk water supply and wastewater treatment capacity thereby
improving water supply reliability/continuity across the Suva-Nausori water supply system. It will also provide bulk
water supply and water treatment capacity to allow the servicing of areas not currently supplied with reticulated
water and to service future growth within the Suva- Nausori water system. Hence, the overall project will increase
the capacity of the Water Authority of Fiji (WAF) to provide safe water and sewerage services to the urban
population of the greater Suva area (GSA) where approximately 30% of Fiji’s population lives. In this context the
water supply subproject will build infrastructure to increase water production by 20% in the GSA.
The project has been classified as Environmental Category B and provides environmental benefits by increasing
access to safe water supply to the Greater Suva Area (GSA) as well as wastewater treatment and management
capacity in the GSA; WAF management and sustainable service delivery capacity will also be improved. The Rewa
River Water Supply Scheme (RRWSS) involves the design and construction of a new river intake and pumping
station on the Rewa River, a 40ML/d new water treatment plant (WTP), 5ML treated water pumping station, a 26km
of DN900 pipeline to connect the WTP to the existing water supply system servicing Nausori and surrounding
areas, and a 10ML water storage reservoir at Waitolu.
1.2 Purpose of the Report
The Terms of Reference (TOR) have been issued by ADB for the Construction Management and Supervision of
RRWSS and includes monitoring and reporting of environmental and social safeguards implementation during
construction as one of its key responsibilities. As stated in the TOR, the scope of services and deliverables for
safeguard compliance are as follows:
Safeguards compliance
• Undertake internal monitoring of the safeguard covenants compliance as per project and loan agreement
and to include in the quarterly safeguards monitoring report
• Facilitate and monitor the implementation of the Construction Environment Management Plan [CEMP]s
prepared by the Contractor for Design, Build and Operate and for Gravity Main Contracts.
• Assist in the monitoring and reporting of the LARP.
• Monitor Contractor / Sub-Contractor compliance with Fiji Labour laws
The deliverable of the Consultant includes semi-annual safeguard monitoring reports (environment, social, gender)
and this report is intended to fulfil this obligation. This report presents the accomplishments of the CS02B (DBO
and GM) for the environmental and social safeguards and gender covering the semi-annual period January 2021
to June 2021.
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 8
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiGeneral Overview
2 General Overview
The basic information of the project (Rewa River Water Supply Subproject), i.e. project owner / employer,
contractor, supervision consultant and the respective representations and the contract packages are presented
as follows:
2.1 Contract Details
Contract No ICB 1.1.1 (DBO)
Contract Sum USD 51,252,237.41
FJD 17,782,685.94
Contract No ICB 1.1.2 (Gravity Pipeline)
Contract Sum FJD 86,581,165.07
Date of Agreement 11 April 2019 (Contract Award Ceremony)
Date of Commencement 01 April 2019
Date of Completion 28 September 2021
Extension of Time 178 days for DBO
Revised Completion Date 23 March 2022 for DBO
2.2 Employer Details
Water Authority of Fiji
General Manager, Special Projects Mr. Sourav Majumder
Project Manager, Special Projects Mr. Rahul Rajneel Sharma
2.3 Donor Agencies
The Republic of Fiji has received financing from the Asian Development Bank (ADB), European Investment Bank
(EIB) Green Climate Fund (GCF) towards the cost of this Urban Water Supply Project.
2.4 Employer Representatives and Consultant
SMEC / EGIS JV
Project Director Mr. Zahid Iqbal (The Consultant)
Employer Representative Vacant (The Consultant) (Senior Project Manager and Team Leader)
Senior Civil Engineer Mr. Stephen Bayley (The Consultant) (Acting Senior Project Manager and
Team Leader)
2.5 The Contractor
SINOHYDRO /HDEC JV (Both Contracts)
Contractor Representative: Mr. Zou Shijun
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 9
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiProject Description
3 Project Description
The RRWSS is one of the sub-projects of the multi-tranche Fiji Urban Water Supply and Wastewater Management
Investment Programme, supported by ADB. This RRWSS sub-project is divided into two (2) contract packages, the
Design Build Operate Package and the Gravity Pipeline Package. The salient features of each of the packages are
described in the following sections.
Contract Packages:
ICB1.1.1 – The DBO Contract is comprised of a raw water intake structure and pumping station on the River Rewa,
40 MLD Water Treatment Plant, (with capacity to increase to 80 MLD in Stage 2 and ultimately to 100 MLD), 5 ML
capacity treated water storage reservoir and pumping station, transmission pumping pipeline and 10 ML service
reservoir at Waitolu.
ICB1.1.2 – Gravity Pipeline Contract comprises the construction of 17.5km of DN 900 steel gravity transfer pipeline
from Waitolu Service Reservoir to a connection point at the eastern end of the Suva-Nausori water system.
3.1 DBO Contract
The Design Build Operate (DBO) package includes the construction of the following facilities:
Table 1: Components of the DBO Contract ICB1.1.1
Facilities and Specifications Location
River Intake, 40 MLD Viria Village, bank of Rewa River
Water Treatment plant Viria Village, bank of Rewa River
Rising Main 8.6km to Waitolu, including the 1.8km
Water treatment plant in Viria to Waitolu
alternative route
Waitolu treated water reservoir 10 MLD Waitolu Village, along the Sawani-Serea Road
Naqali Pipe bridge crossing Naqali
Savu Pipe bridge crossing Savu
Aside from the project facilities, the Contractor will erect temporary facilities to include the following:
Table 2: The list of temporary facilities for the DBO Contract
Facilities Specifications Location
3630 sq. m, accommodates 94 workers Alongside Viria Road, 500 m from
Camp No 1
(Chinese 77 and Local 17) the treatment plant
2 hectares, accommodates 70 workers Along Sawani-Serea Road, 1 km
Camp No 2
(Chinese 46 and Local 24) from junction of Viria Road
2,380 sq. m, accommodates 19 workers (all
Camp No 3 At the Waitolu reservoir
Chinese)
2 hectares, to contain excavated materials East of Camp No 1, near the Water
Disposal Site 1
from rising main works Treatment Plant.
4276 sq. m, to contain excavated materials
Disposal Site 2 from the intake, treatment plant and rising Alongside Viria Road
main works
4018 sq. m to contain excavated materials
Disposal Site 3 At Waitolu Reservoir
from the pipe-bridges and the reservoir site.
4-acre land to contain excavated materials Less than a 1km from the WTP site,
Disposal Site 4
from WTP site. along Viria Road.
2.11-acre land to contain excavated materials Located along Viria Road, less than
Disposal Site 5
from WTP site. 1km from WTP
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 10
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiProject Description
Facilities Specifications Location
Along the Sawani-Serea road,
Material Storage 1A 3291 sq. m approximately 50 meters from
Waidina Riverbank (Naqali)
Approximately 50 meters from
Material Storage 1B 290.75 sq. m
Waidina Riverbank (Naqali)
Junction Nabukaluka-Sawani-Serea
Material Storage 2 5397 sq. m
Road (Nadiva)
200 m from Gusuisavu Bakery along
Material Storage 3 6197 sq. m
Sawani-Serea Road (Durucoko)
Located within the boundary of
Batching Plant 3754 sq. m
water treatment Plant site
Located within the boundary of
Batching Plant 260 sq. m
Waitolu Reservoir
3.2 Gravity Main Contract
The second Contract covers the installation of 17.8km gravity pipeline from the Waitolu Reservoir to a connection
point at the eastern end of the Suva-Nausori water system. This pipeline will be installed along the road reserve
of the Sawani-Serea Road and Prince’s Road. The gravity pipeline component consists of the following:
a. Installation of 17.8km of DN900 steel pipeline with the air valves, scour chambers and hydrant facilities.
b. Construction of Five (5) pipe bridges which are located along the pipeline route as follows:
i. Waidrauso Bridge
ii. Sawani Bridge
iii. Vuniniudrovu Bridge
iv. Sarava Bridge
v. Waila Bridge
The contractor’s temporary facilities are listed in the following table:
Table 3: List of facilities for the Gravity Main (ICB1.1.2) Contract
Temporary Facilities Specifications / Location
2.2 acres, south of Sawani Bridge along Sawani-Serea Road, can accommodate 100
Office/Camp Site 4
workers
Material Storage No 1 2.0 acres, near the junction of Wailase and Sawani-Serea Road
Material Storage No 2 1.1 hectares, 500 m southeast of Navatuvula Village, along Sawani-Serea Road (Naisoso)
Material Storage No 3 1387m2 along the Prince’s Road, Navitoka
0.4 acres, along the Sawani-Serea Road and approximately 100m away from the Wailase
Disposal Site No 1
Settlement.
Disposal Site No 2 3.1 acres, near Navatuvula Village
Disposal Site No 3 2.3 acres, same site camp – camp will be constructed after site is back filled by spoils
Disposal Site No 4 2.0 acres, along Prince’s Road
Disposal Site No 5 Along Sawani-Serea Road near Wailase Settlement
Disposal Site No 6 1.27 acres, along the Sawani-Serea road near Susui Settlement
Disposal Site No 7 0.04 acres, along Sawani-Serea Road and Wailase Settlement
Disposal Site No 8 0.51 acres, along Sawani-Serea Road near Navatuvula Village
Disposal Site No 9 Along the Sawani-Serea Road, area known as Batiki Settlement
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 11
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiProject Progress During January – June 2021
4 Project Progress During January – June 2021
Overall construction was progressing well for both GM and DBO Contracts. However, on the 17th April 2021, a new
outbreak of Covid-19 struck Fiji, whereby Water Authority Fiji authorised the Employer’s Representative on 29th
April 2021 to instruct the Contractor to temporarily suspend all local workers and comply with the directives of the
Ministry of Health in containing Covid-19. This resulted in temporary stoppage of all work on the Gravity Main
Contract and limited work on the DBO Contract. Work on the DBO Contract continued with limited work as the
workforce is mainly made up of Chinese labourers and a few local labourers who are living in the camp facilities.
Construction of the permanent works was severely impacted during the month of May and June during the COVID-
19 pandemic in Fiji. It has also been reported that a number of Chinese personnel are wanting to return to China
due to the increasing number COVID-19 cases in Fiji, while some workers do not want to get the vaccine offered
in Fiji. It is understood that they are waiting for the arrival of vaccines from China which they are willing to take.
4.1 DBO Component
During the semi-annual period January 2021 to June 2021, the following table shows the key activities that were
undertaken and had been achieved:
The status of the facilities under the DBO component is enumerated in the following table:
Table 4: Status of the DBO Construction Works
Facilities & Specifications Location Status
River Intake and pumping Viria Village, bank of No major works carried out during this period.
station Rewa River
Water Treatment Plant and Viria Village, bank of Blinding concrete for the Chlorine Contact Tank,
Storage Reservoir Rewa River Treated Water Tank and Treated Water Pumping
Station was completed, and fixing of steel
reinforcement for the Pre-settling Tank and the
Flocculation and Clarifier Tank was in limited
progress, as was the foundation work for the
Chemical Storage Building and the Gravity Filter.
Overall, the Intake works and the WTP were
assessed by the Employer’s Representative (ER) as
12% and 32.8% physically complete respectively
Pumping Station and Rising Water Treatment Excavation and backfill works in progress for road
Main 8.6km to Waitolu, Plant in Viria to construction
including the 1.8km alternative Waitolu
route
Waitolu Treated Water Service Waitolu Village, along Fifth pour base slab completed with steelwork
Reservoir the Sawani-Serea ongoing for the side walls
Road
Naqali Pipe Bridge crossing Naqali Concrete works have been completed
Savu Pipe Bridge Crossing Savu Concrete works have been completed
The status of the temporary facilities is summarized in the following table:
Table 5: The Status of temporary facilities for the DBO Contract
Facilities Location Status
Camp No 1 Alongside Viria Road, 500m from 100% completed, Dormitories, kitchen and toilet
the Water Treatment Plant facilities are operational.
Camp No 2 Along Sawani-Serea Road, 800m 100% completed, Dormitories, kitchen, office
away from Naqali Village. facilities and toilet facilities are operational.
Camp No 3 At the Waitolu Reservoir 100% completed, Dormitories and toilet facilities are
operational
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 12
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiProject Progress During January – June 2021
Facilities Location Status
Disposal Site 1 Camp No 1 location, near the Water Utilised for Camp 1.
Treatment Plant.
Disposal Site 2 Alongside Viria Road Disposal site not in use.
Disposal Site 3 At the Waitolu Reservoir Utilised for Camp 3.
Disposal Site 4 Less than a 1km from the WTP site, Disposal site in use
along Viria Road.
Disposal Site 5 Located along Viria Road, less than Disposal site not in use, due to bad road condition
1km from WTP
Material Storage Along the Sawani-Serea road, MSCL pipes have been stored at the site.
1A approximately 50 meters from
Waidina Riverbank (Naqali)
Material Storage Approximately 50 meters from MSCL pipes have been stored at the site.
1B Waidina Riverbank (Naqali)
Material Storage Junction of Nabukaluka Sawani- This site has been abandoned; the Contractor has
2 Serea Road (Nadiva) no plans on using this site
Material Storage Near the Gusuisavu Bakery along MSCL pipes have been stored at the site.
3 Sawani-Serea Road (Durucoko)
WTP Concrete Located within the boundary of the In use for concrete production
Batching Plant Water Treatment Plant
Waitolu Located within the boundary of the In use for concrete production
Reservoir Waitolu Reservoir
Concrete
Batching Plant
The following photographs in Figure 1 shows the status DBO works for the period January – June 2021:

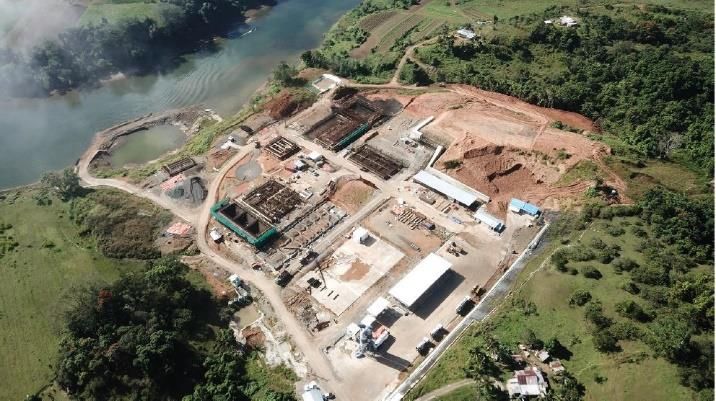

Image 2: Aerial view of WTP site – 22/06/2021

Image 1: Batching plant sediment pond – 06/04/2021
Image 3: WTP SRP – 19/04/2021 Image 4: Crib retaining wall for slope protection –
19/04/2021
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 13
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water

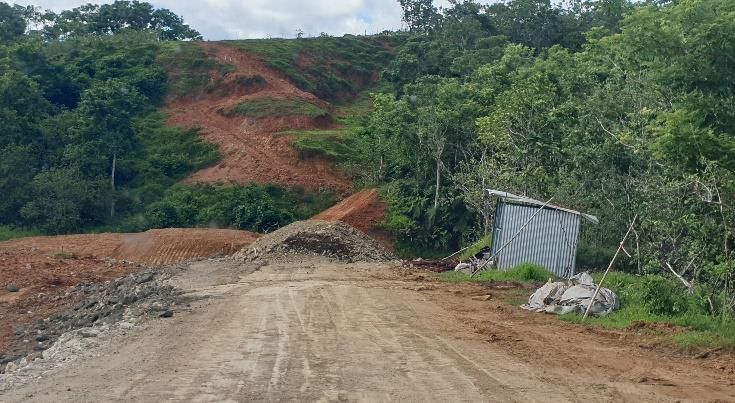

Supply Scheme
Prepared for Water Authority of FijiProject Progress During January – June 2021
Image 5: Chlorine Contact Tank Building– 19/04/2021 Image 6: Cofferdam– 12/04/2021
Image 7: Private road– 12/04/2021 Image 8: Rising Main Pipe Installation– 09/04/2021
Image 9: Savu Pipe Bridge – 19/04/2021 Image 10: Waitolu Reservoir 25/05/2021
Figure 1: Current status of DBO Construction Site
4.2 Gravity Main Component
Overall progress was greatly affected during the reporting period due to a new outbreak of COVID-19 cases in Fiji,
whereby the Water Authority of Fiji authorised Employer’s Representative on the 29th April 2021 to instruct the
Contractor to temporarily suspend all local workers and comply with the directive of the Ministry of Health in
containing COVID-19. This resulted in temporary stoppage of all work on the Gravity Main Contract.
The following table shows the key activities that were undertaken and had been achieved:
The status of Contractor’s temporary facilities is listed as per table 6 below.
Table 6: Status of Gravity Main Construction Works
Facilities Status
Office/Camp Camp construction has been completed.
Site preparation works have been completed, MSCL
Material Storage No 1 (Wailase)
pipes have been stored at the site.
Site preparation works have been completed, MSCL
Material Storage No 2 (Naisoso)
pipes have been stored at the site.
Material Storage No 3 (Navitoka) Abandoned, will not be utilized by the Contractor
Disposal Site No 1 Disposal site not in use
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 14
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiProject Progress During January – June 2021
Facilities Status
Disposal Site No 2 Disposal site in use
Disposal Site No 3 Camp 4 has been constructed on this site.
Disposal Site No 4 Disposal site in use.
Disposal Site No 5 Disposal site not in use
Disposal Site No 6 Disposal site in use
Disposal site not used for dumping excavated soil –
Disposal Site No 7 however used to store sand for backfilling in the
trench
Disposal Site No 8 Disposal site in use
Disposal Site No 9 Disposal site in use
Construction work was in progress until suspended on
Waidrauso Bridge crossing
29th April 2021 due to COVID-19 outbreak
Construction work was in progress until suspended on
Sawani Bridge crossing
29th April 2021 due to COVID-19 outbreak
Construction work was in progress until suspended on
Vuniniudrovu Bridge crossing
29th April 2021 due to COVID-19 outbreak
Construction work was in progress until suspended on
Sarava Bridge crossing
29th April 2021 due to COVID-19 outbreak
Construction work was in progress until suspended on
Waila Bridge crossing
29th April 2021 due to COVID-19 outbreak
Underground Pipeline Installation
The following photographs in Figure 2 shows the status of Gravity Main pipe installation site for the period January
– June 2021:
Image 12: Pipe laying (Prince’s Road)– 26/03/2021
Image 11: Pipe laying (CH2485-CH3800)– 26/03/2021
Image 13: Waila Pipe Bridge – 22/03/2021 Image 14: Sawani Pipe Bridge – 22/03/2021
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 15
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiProject Progress During January – June 2021
Image 15: Pipe laying (CH2485-CH3800 – 22/03/2021 Image 16: Pipe laying (Prince’s Road)– 12/03/2021
Image 17: Waidrauso Pipe Bridge – 12/03/2021 Image 18: Site barricaded – 06/04/2021
Image 19: Pipe Installation Works– 28/04/2021 Image 20: Pipe Installation Works 23/04/2021
Figure 2: Current status of Gravity Main pipe installation site
4.3 Planned Work for Next Quarter (July to September 2021)
DBO Contract
Water Treatment Plant
• Intake Valve Station – complete base slab concrete pouring
• Flocculation and Clarifier Tank – complete base slab concrete pouring, complete steel fix for side wall
• Gravity Filter – complete base slab concrete pouring, sidewall steel and formwork and complete side
wall concrete pouring
• Treated Water Pump Station – complete base slab concrete pouring
• Chlorine contact and treated water tank - complete base slab concrete pouring
• Wash water holding tank and pump station – complete side wall concrete pouring
• Chemical Storage building – complete column steel fix and backfilling
• Coarse Settling basin – complete side wall concrete pouring
Private Road – complete general excavation and backfill, complete box culvert, complete pipe culvert backfills
Rising Main – continue pipe laying works
Waitolu Reservoir – complete side wall concrete pouring.
Pipe Bridge
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 16
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiProject Progress During January – June 2021
• Complete Pipe Bridge construction of Naqali Pipe Bridge
• Complete Savu Bridge
Gravity Main Contract
• Increase installation of gravity pipeline work front on other sections of Prince’s Road
• Increase installation of gravity pipeline work front on other sections of Sawani-Serea Road
• Complete construction works on the Pipe bridges
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 17
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiEnvironmental Safeguards Monitoring
5 Environmental Safeguards Monitoring
5.1 Status of Compliance with Environmental Safeguards Monitoring
Environmental Monitoring Checklist
Environmental Safeguards Compliance Monitoring Checklist for ICB1.1.1 and ICB 1.1.2 Contracts
The checklist is a compilation of the conditions of approval issued by DoEnv for DBO and GM CEMPs
(Construction Environmental Management Plan.
Table 7: DBO CEMP Compliance Status
DBO CEMP Approval Condition Comments
Project signage installed with relevant Project sign boards have been installed at Waitolu Reservoir,
contact details. WTP site and Naqali (camp 2) site.
Working hours from 7am to 7pm. No works were carried out outside the normal working hours
Vegetation clearance is restricted to the
No vegetation clearance was conducted during this reporting
WTP, Rising Main, Camp sites and Waitolu
period.
Reservoir only.
Vegetation removed should be mulched (in
a dedicated area) and reused during Vetiver grass is planted on some of the exposed sloped areas.
rehabilitation of disturbed areas
Viria road dries very quickly and readily generate dust on non-
Dust generated by construction activities rainy days. The Contractor has to be reminded frequently to
should be controlled at all times by initiate dust suppression, although no issue was recorded in the
dampening with water second quarter of this year as works were limited to WTP site
only
Stockpiles must be covered with tarpaulin Stockpile will be covered when it is required, however, to date
or geotextile materials during windy no issues recorded on dust from soil stockpiles as the soil is
conditions normally levelled or flattened at the dump sites
Mud deposits and skid marks on the road has been an issue for
almost all disposal sites. The Contractor is frequently lax in
Mud and silt from wheels of trucks and
mitigating skid marks on the tarseal road.
machineries must be washed off before
It is expected that the Contractor will wash the road at the end
leaving the stockpile and disposal waste
of the day, however, this is not always carried out, since traces
of mud and skid marks are still seen on the road in the morning.
Soil and boulders must be securely
covered whilst transporting them on public Haulage trucks are currently not using tarpaulin however the
roads. Spillage on public road must be load is below the box bed.
cleaned up immediately
Sediment control device are properly Silt fence, vetiver grass, and slope protection work is being
functioning implemented at the site.
Exposed areas at Waitolu Reservoir, camp sites, private road
Exposed areas are re-vegetated and WTP site have been re-vegetated or protected with
vegetation enabling Geotech or a crib wall.
Water intake work undertaken during dry No works being carried out at the cofferdam during this
period. monitoring period.
Cofferdam construction have been completed; works are
Cofferdam installed and river flow diverted
pending until the end of the wet season.
Effective construction site drainage must
be put in place to direct runoffs to
Site drainage at the WTP site is subject to further improvements
sediment traps before it is discharged to
any water course.
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 18
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiEnvironmental Safeguards Monitoring
DBO CEMP Approval Condition Comments
Excavated material hauled to the disposal
Excavated soil are being stored at the disposal areas
areas
Burning of construction or general waste is
No burning has been undertaken at any site.
prohibited
All general solid wastes are stored in
Skip bins and small rubbish bins are provided at all sites.
proper bins
All general solid wastes are stored in A waste recycling company (Carpenters) have been engaged to
proper bins and disposed of at an replace full bins as required. For disposal at Naboro Landfill,
approved Department of Environment however the Contractor is often reminded to empty the skip
approved disposal site. bins when wastes are seen lying outside the skip bins.
Camp 1 – Water is pumped from the Rewa river and treated at
the site.
Camp 2 – borehole has been installed and treated at the site
Water supply in place at the camp site and
before supplied to other sites
construction site
Camp 3- Drinking Water is supplied from camp 2. Borehole is
also installed, and the water is used for other non-potable
needs.
Toilet at all camp sites is in operation. Proper Toilet (Flush Toilet
system) is in operation at the WTP site. Portable toilet is placed
Wastewater system in place at other construction sites including Viria Private Road, and for
Naqali and Savu Bridge when required (i.e. when works are
operational).
A waste management company has been
contracted to service and dispose of waste Waste Clear Company is engaged to bail out portable toilet and
(black water) to the Kinoya sewage permanent toilet at camp sites.
treatment plant
Separate toilet facilities for men and
Separate toilet facilities are provided for men and women.
women are provided at the campsite
Fuel is being stored at the fuel tank provided at Camp 1 and
Hazardous materials stored in a locked and
Camp 2 site. Fuel truck is being used to deliver fuel to the site
bunded containers.
when refuelling machines.
Recycling of paper and plastic bottles is practiced on site but
Waste recycling is practised on site
needs improvement
Heavy machinery is in operation only during normal working
Noise is monitored on site
hours and maintained in good working conditions.
Regular service of vehicles to control All vehicles are serviced regularly, and emission are visually
emissions monitored daily by the Contractor.
Spill kits are placed in the fuel truck and at the fuel storage site
Spill kit is available at the site
(camp 2).
Water truck is available to suppress dust at all sites when
Dust suppression in place
required, however dust suppression is not done always.
Material Storage Area for construction Currently Nakorolevu 1A & 1B and Durucoko Material Storage
materials are available and managed sites are being used, while Nadiva site will not be utilised.
Affected villages are informed of the work
schedule if working outside normal working Communities have been informed during the public consultation.
hours
A number of times it has been witnessed that traffic is not well
Traffic Management in place
managed on the public road
Excavated sites are barricaded with caution tapes and with
Excavation site are barricaded with caution water filled barricades on the road as standard procedure,
tapes however a number of times it has been witnessed deep
trenches are not barricaded.
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 19
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiEnvironmental Safeguards Monitoring
DBO CEMP Approval Condition Comments
Construction sites particularly along the Reflective sign boards and barricades are used. No lights are
main road should be lighted and visible at used on site at night to make applicable construction sites more
night and use reflectorized signs visible for road users.
Affected pedestrian walkways are restored Walkways at the WTP site are restored when affected.
No tipping of soil into the riverbank or into
No tipping of soil is conducted into the river
the river
Gabion wall work is being stopped due to the frequent flooding
Installation of gabion basket to stabilise
in the Rewa River. The works are expected to recommence in
the slope along the riverbank if necessary
next quarter.
Water pumped out from the cofferdam
should be directed to a siltation tank or No work is conducted at the cofferdam during the wet season.
pond before discharge into the River
Refuelling of machines to be done 100m
away from the river in a bunded area using Refuelling of machinery is conducted away from the river/creek
proper refuelling equipment
Warning signs e.g. Flammable, No smoking,
etc shall be posted at the construction site Few hazardous warning signs are installed. No smoking sign
especially at the WTP site, Reservoir site boards are needed at the camp sites and at the refuelling areas.
and camp site
Hazardous waste are disposed of properly None was disposed during this reporting period.
It has been noted that waste segregation is not practised at the
Waste segregation is implemented on site
camp sites.
Proper rubbish bins and skip bins are
Proper rubbish bins are provided at all sites.
available on site
Wastewater Treatment System is in place.
All wastewater from toilets, bathroom, and Liquid waste from toilet, bathroom and kitchen are connected to
kitchen shall be conveyed to the septic the septic tank for all camp sites.
tank.
Aggregates Supplier are as follows.
• Flame Tree Quarry and Aggregates
Construction aggregates are sourced from • Winstone Aggregates (Fiji)
an approved licenced source • All Earthworks Limited
• Fushun Farm Ltd
• Yue Engineering Company Fiji Limited
SHJV maintaining continuous
Local communities are informed through the public consultation
communication with the local communities’
and the monthly Grievance Redress Mechanism (GRM)
residents and government stakeholders
meetings.
during the construction phase
An EMC is established at the site and shall
An EMC has been established and has been conducting monthly
consist of the following members including
site inspections and meetings at the camp site 2 since October
DoEnv, NTC, Naitasiri Provincial Office,
2019.
DTCP, DoL, FRA, SHJV WAF
Demobilise workers and equipment upon
Not Applicable at the moment.
completion of construction
All equipment structures and waste
material from the work sites, construction Not Applicable at the moment.
camp, stockpile areas are removed
Rehabilitation of the land according to the Rehabilitation plan will be carried out upon completion of the
Engineer or agreement with the landowner project.
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 20
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiEnvironmental Safeguards Monitoring
Table 8: GM CEMP Compliance Status
GM CEMP Approval Condition Comments
Copy of approval conditions is kept on
Copies of all approvals are available at the main office in Naqali
site and made available upon request
(Camp Site 2)
together with CEMP report copy.
All personnel engaged in the activity are
appropriately trained to understand and Environmental induction is conducted to all new employees
comply with CEMP conditions.
A copy of complaint register must be All grievances are recorded and registered via grievance
kept to record any environmental issues redress form. To date no complaints on environmental issues
from the general public has been received
Special Conditions
Project signage installed with relevant Project sign boards have been installed at Waitolu Reservoir,
contact details. WTP site and Naqali (camp 2) site.
Working hours from 7am to 7pm. No works were carried out outside the normal working hours
Construction works must cease during Workers are informed to stop work during period of heavy rain
period of heavy rain and adverse weather at the construction sites (outdoor), while the works that could
conditions be done indoors and in sheds are carried out.
Proper signage must be placed around the
Warning sign boards are placed at the construction areas
working areas to warn the public
Site clearance is only carried out within the immediate vicinity of
Site clearance must be restricted to the
the work (i.e. FRA’s Road Reserve) and any other areas as
17.8 km
agreed by the landowner.
Vegetation removed should be mulched (in
a dedicated area) and reused during Not applicable at the moment.
rehabilitation of disturbed areas
The issue on the ad hoc disposal of excavated soil from the
Topsoil removed during site preparation
trench has been frequently seen along the Sawani-Serea road. It
and construction must be stabilized and
has been noted that the Contractor is not dumping the soil at
covered with grass at the stockpile area.
the approved disposal areas.
Stockpiles must be covered with tarpaulin Stockpile will be covered when it is required, however, to date
or geotextile materials during windy no issues recorded on dust from soil stockpiles as the soil is
conditions normally levelled or flattened at the dump sites
Mud deposits and skid marks has been an issue at disposal sites
Mud and silt from wheels of trucks and and pipe installation sites. The Contractor is very inefficient in
machineries must be washed off before mitigating skid marks on the tar sealed road.
leaving the stockpile and disposal waste It is anticipated that the Contractor is washing the road at the
end of the day.
Haulage trucks must be covered with Haulage truck are currently not using tarpaulin however the load
tarpaulin is below the box bed.
Burning of waste is prohibited No burning activity is conducted at the site.
Sediment treatment ponds, silt fence and Sediment pond are installed at both Material Storage Area and
sediment trap must be put in place silt fence installed at the pipe bridge sites
Necessary measures must be taken to Silt fence are installed at the riverbank for all the Pipe Bridge
ensure aquatic environment is protected Sites (Sawani, Waidrauso, Sawani, Vuniniudrovu and Waila) for
from land-based construction at all times. sediment control measures).
Regular weekly inspection and
inspections following heavy rain events
Regular inspection is carried out by the ER and Sinohydro EHS
must be undertaken to ensure that
team to ensure compliance at the project site
sediment control measures area operating
effectively
Stockpiles to be located 100m away from The Naisoso stockpile boundary is not high and is located
any watercourse approximately 40m from the Waimanu River. However, the
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 21
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiEnvironmental Safeguards Monitoring
GM CEMP Approval Condition Comments
boundary line towards the river is occupied with thick
vegetation that acts as a buffer.
Ensure that construction activities
produce minimum vibration. Mitigation Heavy machinery is in operation only during normal working
measures must be in place where vibration hours and maintained in good working conditions
activities are likely significant.
Waste management plan is in place. Proper skip bin is available
Waste Management Plan in place which is being serviced by the service provider Carpenters
Shipping. Portable toilet is serviced by Waste Clear company.
Refuelling of vehicles must be 100m
away from any watercourse in bunded
Refuelling is carried out away from the river at all the sites.
area to contain spill. Fuel storage must be
bunded.
Sediment control device are properly
Slope protection work is being implemented at the site.
functioning
Excavated material hauled to the disposal
Excavated material transported to disposal areas.
areas
Burning of construction or general waste is
No burning has been undertaken at any site.
prohibited
All general solid wastes are stored in
Skip bins and small rubbish bins are provided at all sites.
proper bins
All general solid wastes are stored in
proper bins and disposed of at an A waste recycling company (Carpenters) has been engaged to
approved Department of Environment replace full bins as required. For disposal at Naboro Landfill.
approved disposal site.
Water supply in place at the camp site and
Camp 4 – Water is supplied through WAF’s main.
construction site
Toilet at all camp sites are in operation. Proper Toilet (Flush
Wastewater system in place Toilet system) is in operation at the Sawani Campsite. Portable
toilet is placed at other construction sites
Spill kits and Spill procedures in place
for the management of any fuel or
chemical spill. Any accident spillage Spill Kit is available at the Fuel Truck.
must be reported to the DoEnv within
24hours
Hazardous substance and construction
materials must be stored in a designated
safe and secure area. The Material Safety
Data Sheet [MSDS] for all
hazardous materials stored onsite must be All hazardous materials are stored in the warehouse.
outlines in a site register at the site office
and kept available to all personnel
expected to come in contact with those
chemical.
Maintain continuous communication
with the local communities/residents and Communities are informed through consultation including
government stakeholders during the direct contact with the village headman and landowners.
construction phase.
EMC established under CEMP approval EMC is overlooking the progress on site. During this monitoring
must also be responsible to oversee this period three field meetings were conducted for the month
CEMP approval implementation January to March, no meeting was conducted in April due to
DBO CONTRACT ICB 1.1.1 AND GRAVITY MAIN CONTRACT ICB SMEC Internal Ref. 22
1.1.2: SEMI-ANNUAL SAFEGUARDS MONITORING REPORT FOR 5035017
JANUARY TO JUNE 2021 16 August 2021
Construction Management and Supervision of Rewa River Water
Supply Scheme
Prepared for Water Authority of FijiYou can also read
